Alignment and installation of two MaK 8M32C engines

PRECISION ENGINE ALIGNMENT FOR FERRY OPERATOR IN GREEK SHIPYARD

A Greek ferry operator made the decision to replace the 30- year-old engines onboard one of its vessels with two new MaK 8M32C diesel main propulsion engines.

The welding preparations and rigging were handled by the shipyard personnel, but the owner sought Goltens’ expertise for proper installation of the engines on the foundations. This included precision alignment of the engines to the gearboxes and chocking of the engines in place.

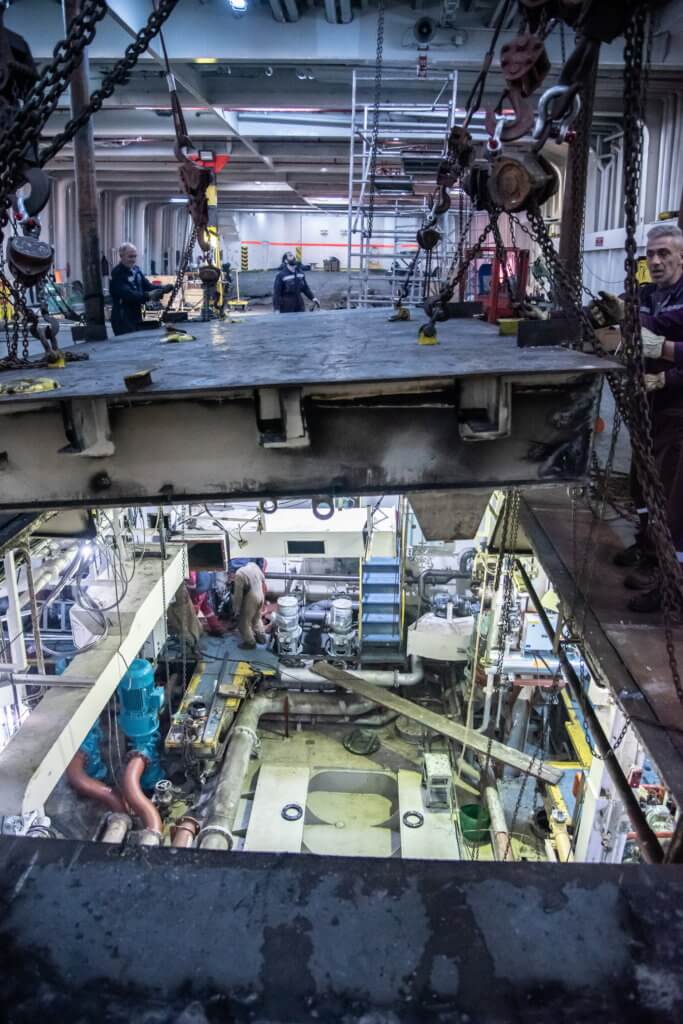

  • Deck removal for installation of 2 new MaK 8M32C engines

    Removal of the deck to allow for engine rigging

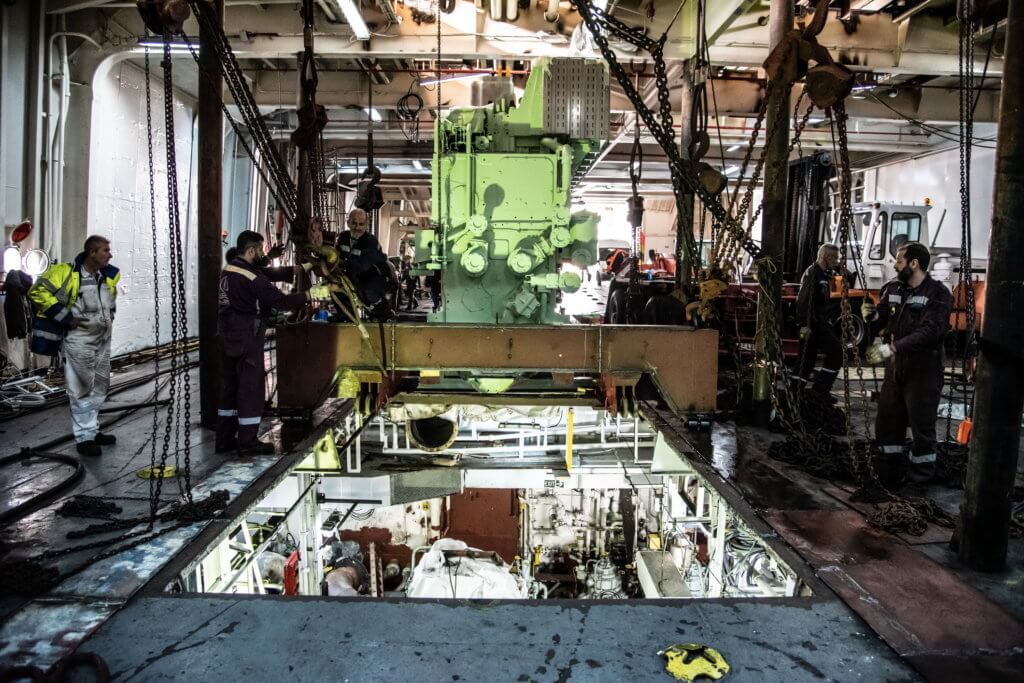

  • Installation of MaK 8M32C engine on ferry in Greece

    MaK 8M32C being slid into position on skid

  • Lowering of MaK 8M32C engine into place

    Lowering the engine into position above foundation

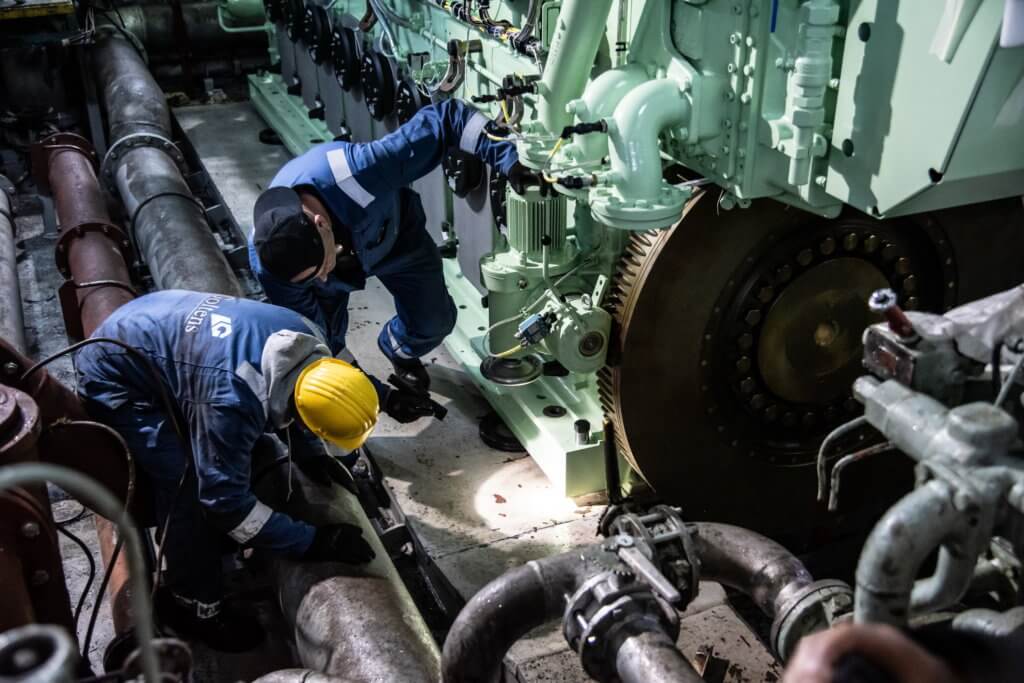

  • Inspection of replacement MaK 8M32C engine placement on foundation

    Inspection of engine placement on large metal spacers

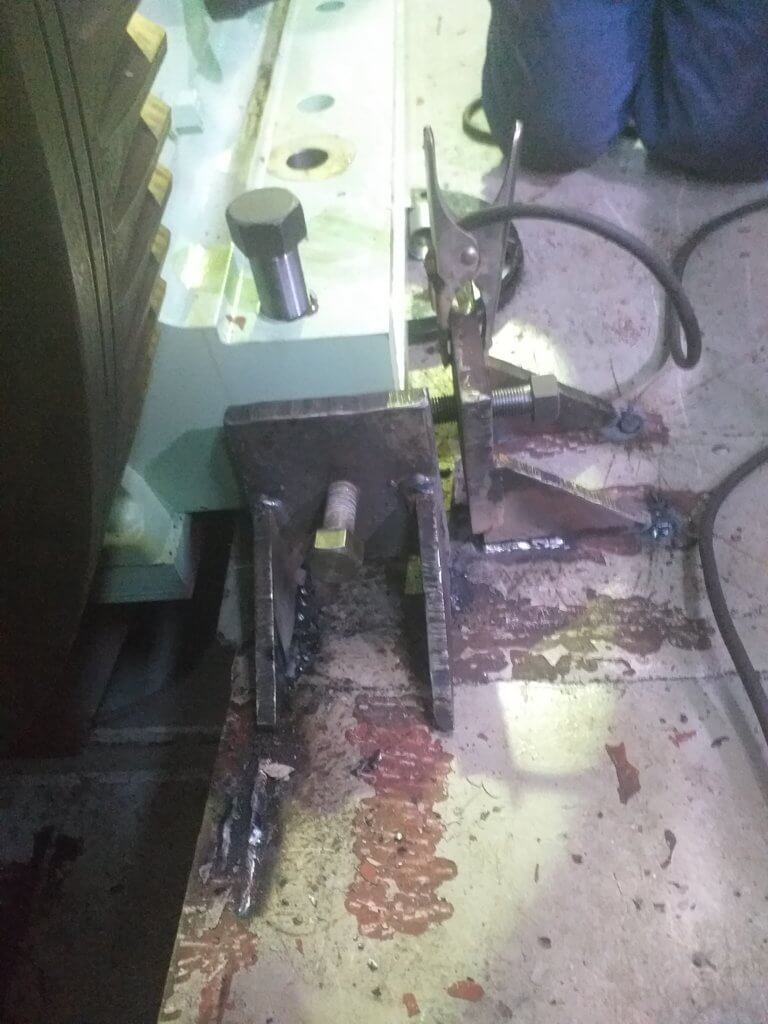

  • Jacking bolts installed for alingment of new MaK 8M34C engine

    Jacking bolts installed

  • Laser alignment of MaK 8M32C to gearbox

    Laser alignment checks on engine and gear box

  • Foundation bolt drilling for alignment of MaK 8M32C engine

    Preparing drill for foundation bolt drilling

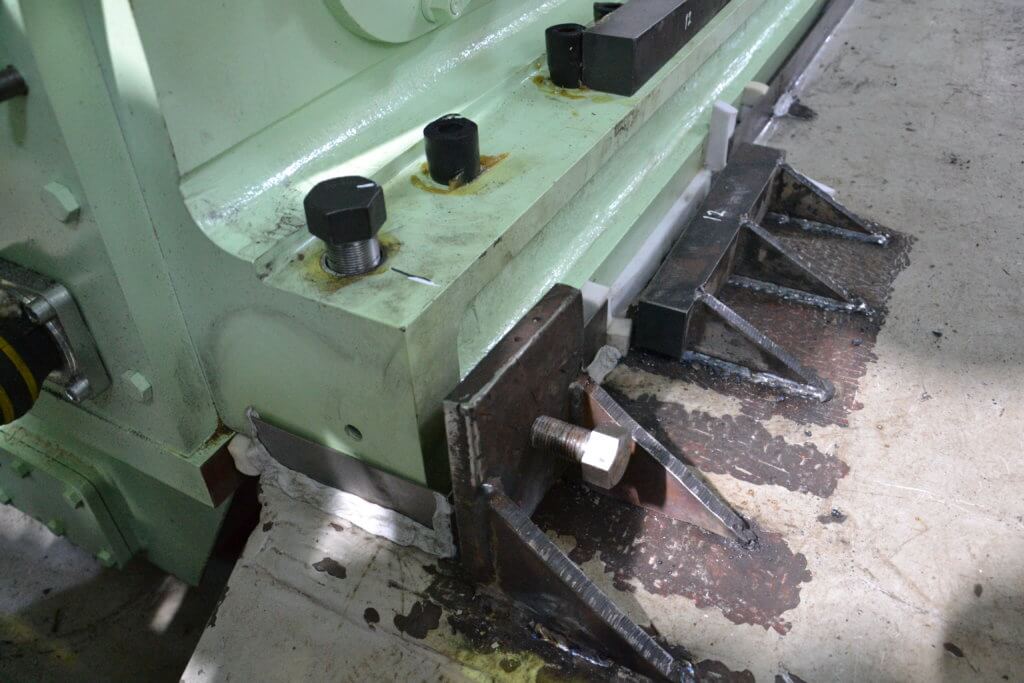

  • Damming and sidestopper installation prior to chockfast

    Damming and sidestopper installed prior to chocking

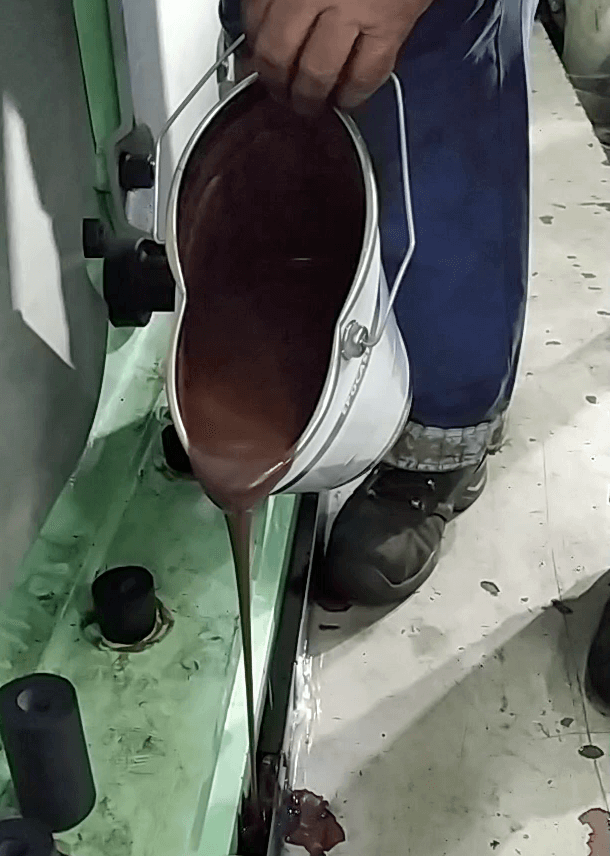

  • Pouring Chockfast for installation of MaK 8M32C engine

    Pouring the Chocking compound

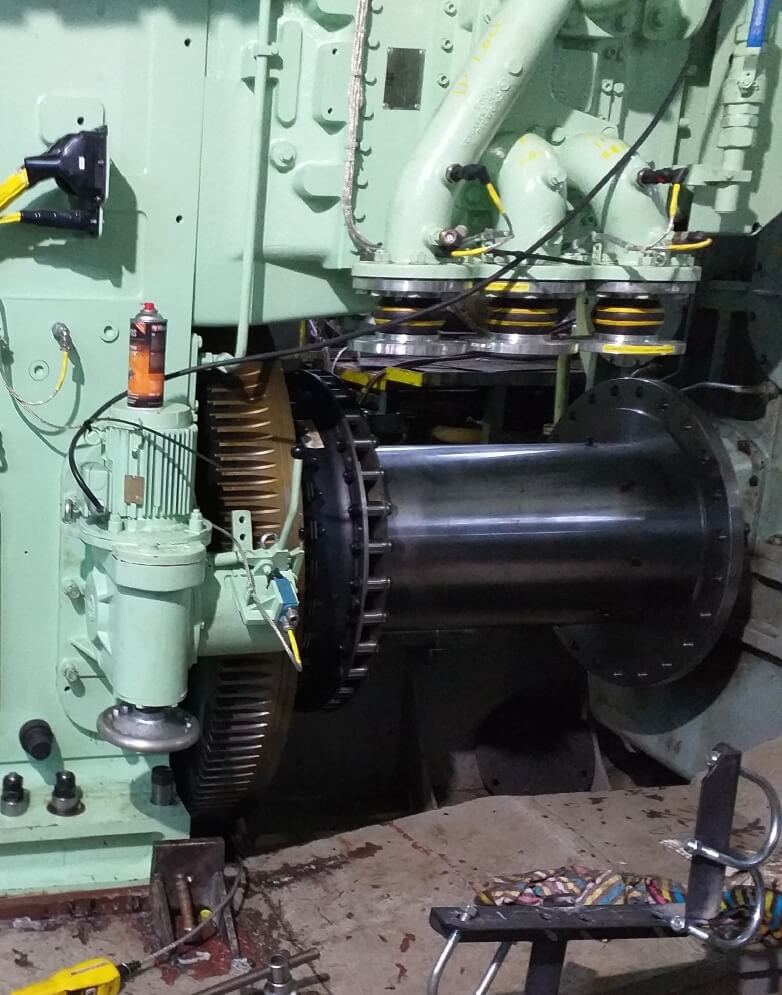

  • Vulkan coupling installed on new MaK 8M32C engine

    Vulkan coupling installed

PROJECT EXECUTION:

Goltens prepared the detailed installation and chocking plan for class submittal and deployed a team to the site. Upon arrival, the port engine had already been lowered into position and Goltens proceeded to weld the jacking plates in place and move the engine to set the correct axial alignment distance for the Vulkan coupling. During this time the starboard engine was lowered into position and work on the engines began in parallel.

Once Goltens completed the thermal growth calculations, the team performed laser alignment to move the engine into the final position. The team then drilled all foundation bolt and fitted bolt holes and welded the prefabricated collision chock brackets in place. The final alignment checks, including crankshaft deflections, were then taken prior to chocking the engine. The damming material was then installed, and the chocking material was poured.

After curing of the chocking compound, the foundation bolts were installed, the fitted bolt holes were reamed to their final dimension and fitted bolts were final machined and installed. Once all bolts were installed, they were tensioned to spec. and final alignment confirmed. The team finalized the job with the installation of the Vulkan flexible couplings and fitted the collision chock wedges.

RESULTS:

The overall job was successfully completed over a 40-day period by a 2-man team of alignment specialists. The installation was inspected and accepted by the Class.
